WHO WILL PAY NOVA SCOTIA FOR UNUSED MARITIME LINK?

The
2041 Group, which included several capable lawyers, spent many a night
parsing the contracts which contained Nalcor’s commitment to Emera for the Nova
Scotia Block (that’s the free electricity). Then there’s another set that
commits one terawatt hour at a price set by auction at the New England bar.


The
group watched
in horror as Nalcor openly backed itself into a corner as it
continued to spend tens of millions on the Muskrat Falls project knowing, as it
did, that the Federal Government had given veto power to Nova Scotia over award
of the Federal Loan Guarantee (FLG)
and thus project sanction.

By
the time Bruce Huskilson, Emera’s CEO, had finished shaking down Ed Martin, the
UARB
the equivalent of our PUB, acting on behalf of the Government of Nova Scotia must have known Nalcor would agree to any demand to get sanction.

Nalcor’s
behavior has always contradicted the rules of common business practice, and of
common sense.



One
of Nalcor’s claims
about which I have always been skeptical is its
assertion that there is no recourse for Emera with respect to a delay in providing
the electricity committed under the provisions of the Nova Scotia Block. Implicit
in the suggestion is that the $1.5 billion Maritime Link (ML) could be
completed two or more years in advance of Muskrat Falls’ electricity generation
without any obligation by Nalcor, the party responsible to provide compensation
for the unused asset.

The
cost of servicing the ML debt, together with depreciation and other related
expenditures, is estimated at approximately $180 million per year.

In
2014, Nalcor stated: “There is no compensation associated with a delay. This is
addressed in the Energy and Capacity Agreement also available on the project
website. The commitment to provide energy to Nova Scotia starts with
commissioning of the third generating unit at Muskrat Falls and continues for
35 years from that event.”

This arrangement is out of character for a mature
company like Emera, which would be expected to protect their shareholders
against non-performance by another contracting entity. It is a fundamental principle of the law of
contracts. Evidently Emera believes that,
for its part, the shareholders are protected.

Recently, some clarity was provided to this
question by Nova Scotia’s UARB. That Board has instigated a Hearing for April 10, 2017 and established a Preliminary Issues List in consequence of an action by
Emera subsidiary Nova Scotia Power
(NSP). That company is seeking to recover the cost of delay to the Muskrat
Falls Generation Facility through the Nova Scotia ratepayers.
The company is attempting to recover $162 million in 2018 and another $164 million in 2019.

Those costs have been included in the
application to the UARB (which can be found in the above link):

Emera plans to deliver the Maritime Link on
time and on budget. Nalcor has confirmed a delay of at least two years on the
dam.

In seeking this $326 million in payments
prior to delivery of the Nova Scotia Block, Emera argues that the Nova Scotia
ratepayer will see benefit with the early commissioning of the Maritime Link,
which justifies the early recovery. Emera
states:

The Maritime
Link provides a strategic transformational opportunity for enhanced access to
competitive energy markets and should be made available for the benefit of Nova
Scotia customers immediately upon commissioning… With the completion of the
regional energy loop created by the Maritime Link, NS Power will be
well-positioned to access competitive energy markets in a manner not previously
possible to obtain value through the import (or export) of energy via the
Maritime Link.”
Early
commissioning of the Maritime Link may provide some value to Emera and the ratepayers of NS, but the company doesn’t circumscribe its claim
at least not yet
and has seemingly set out to establish who will pay in any event. For that
reason, unless Nalcor completes the ML roughly simultaneously with completion of the Labrador Island Link
and deliver the 1000 GWH committed under the
Nova Scotia Block
we need to ask: who will pay this $326 million which Emera is
seeking?

One thing we can safely assume is that the
UARB won’t happily allow early recovery from the NS ratepayers, without delivery
of the Nova Scotia Block, of all the costs sought by Emera.

Unlike
the PUB of this province with respect to Muskrat, the UARB is empowered in Nova
Scotia to review all matters pertaining to the ML. The UARB has shown that it
will challenge Emera’s subsidiary, Nova Scotia Power, to the benefit of the NS
ratepayer. The Dunderdale Government
removed the PUB’s review of the Muskrat Falls project when it refused to
endorse the scheme. The Ball Administration has failed to give the Board a new
mandate regarding the project.

What
is likely to result from the UARB Hearings? One possibility is that the UARB will
compromise, allowing a partial recovery of the ML costs. Undoubtedly, linked
to any such decision will be the amount of energy, if any, which will be available from
Newfoundland and Labrador prior to completion of the ML.

(A
short primer: If Nalcor completes the LIL by the end of this year
Stan
Marshall having suggested that that’s the intention, even if some engineers believe he
is a bit optimistic
— then Nalcor can use the roughly 80 mW of Recall power which
Hydro Quebec is currently selling for this province. Nalcor can also utilize
surplus power from Islandbased hydro sites to help make up the difference. But
that power won’t be available during the highdemand winter months
except if
Nalcor runs Holyrood thermal or buys it from Hydro Quebec. The reader should
note that the Recall power is part of Nalcor’s current revenue stream
which
will be lost if it is given over to the Nova Scotia Block. Thermal energy from
Holyrood won’t be cheap. And power purchased from Hydro Quebec won’t be free,
either.)

The
question remains, if Nalcor fails to deliver any of the power it has committed
to NS, what does Emera do if the UARB does not approve the full $326 million
over 2 years? Who pays the shortfall?

It
is worth reading the language of the Maritime Link Joint Development Agreement.
Article 8 refers to the financing of the
project. Within this section it makes
reference to Emera’s ability to make an application to the UARB for recovery of
the Projected Overrun and applicable AFUDC. AFUDC accounts for the interest on the debt, and the return on equity
used during construction.

The question is this: do the
costs associated with Nalcor’s failure to supply the Nova Scotia Block
commensurate with the completion of the ML constitute a cost overrun?

Put a different way: With Emera
having made an application to adjust the UARB Approved Amount due to the
additional capital costs, and to the AFUDC during the delay, would the UARB
rejection or partial rejection of the cost make Nalcor exposed to the
“Unapproved Overrun plus any Financing Costs” as outlined above?


Lets face it: $326 million
is a lot of money. The NS ratepayer will
not want to pay it, Emera will not want to pay it, and Nalcor will not want to
pay it.

The language in the Martime
Link Joint Development does not afford a definitive conclusion. But the many references to Nalcor’s responsibility
for part of the capital and financing costs not approved by the UARB are a

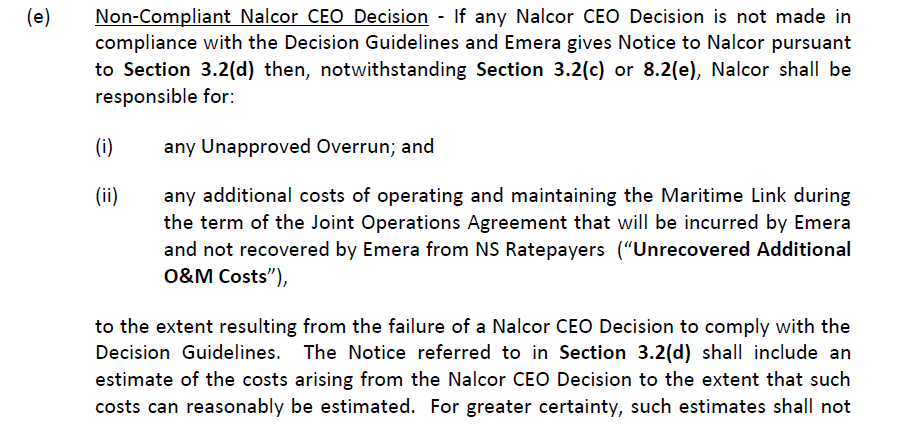

cause for concern.  From section 3.2:

In short, the Application before the UARB
raises many questions: What is the alternative source of power which could
squelch Emera’s claim to the UARB? If the available Recall is part of this
“solution”, which group of ratepayers
NS or NL will have priority access to this
cheap energy? If the UARB declines Emera’s Application, does that company have
recourse to Nalcor for the additional costs, given the contract language shown
in the above Exhibit?

Nalcor could have an exposure here of several
hundred million dollars.

Likely Nalcor as in the case of the Quebec Superior Court’s decision on the Upper Churchill Renewal Agreement and how it impacts the Water Management Agreement will offer the usual assurance that there is no problem here.

A better option is for the public to give some attention to the issue during, and following, the UARB Hearings. When it comes to transparency, Nalcor could learn a lot from that agency..
